EPCC TANK 603

TANK 603 PROJECT

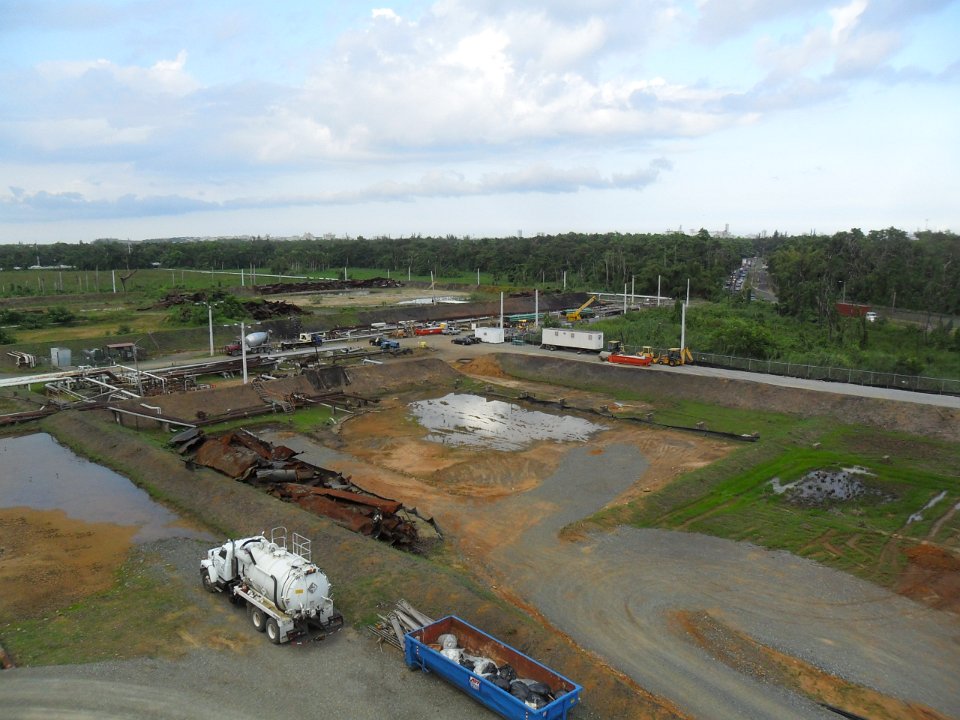

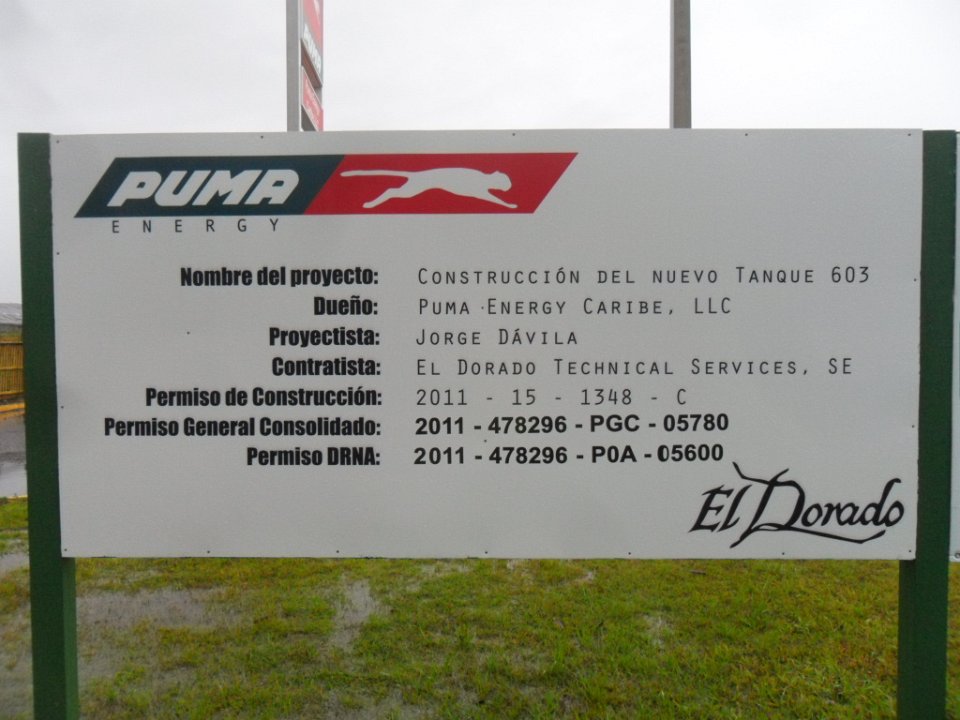

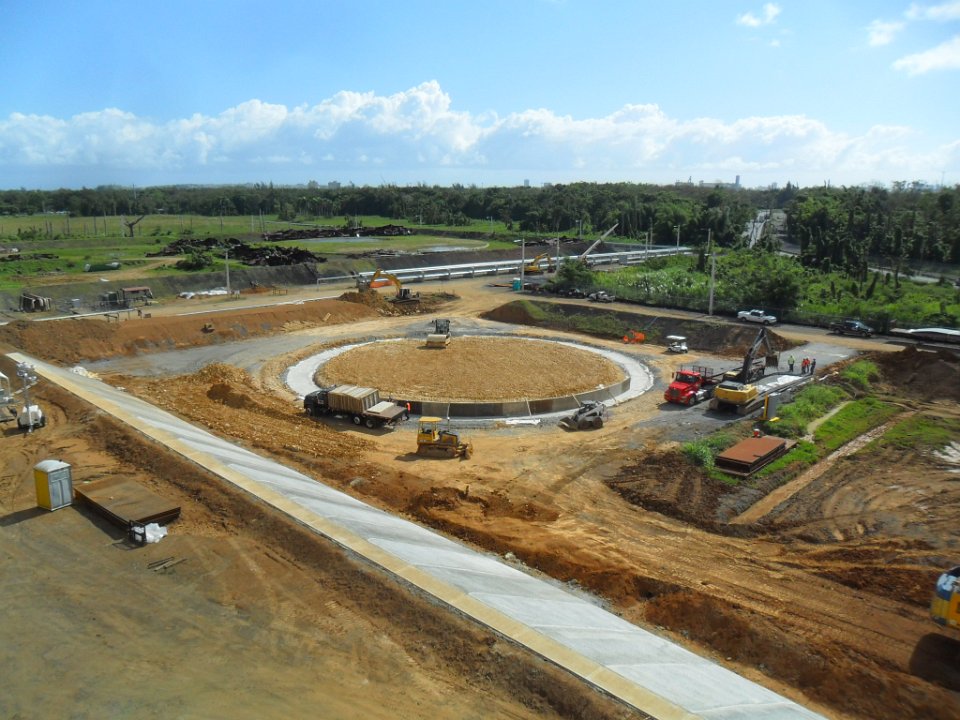

Project Permit 1 INITIAL CONDITION 2 SITE PREP AND SOIL STABILIZATION 3 CONCRETE RING FOUNDATION PREPARATION

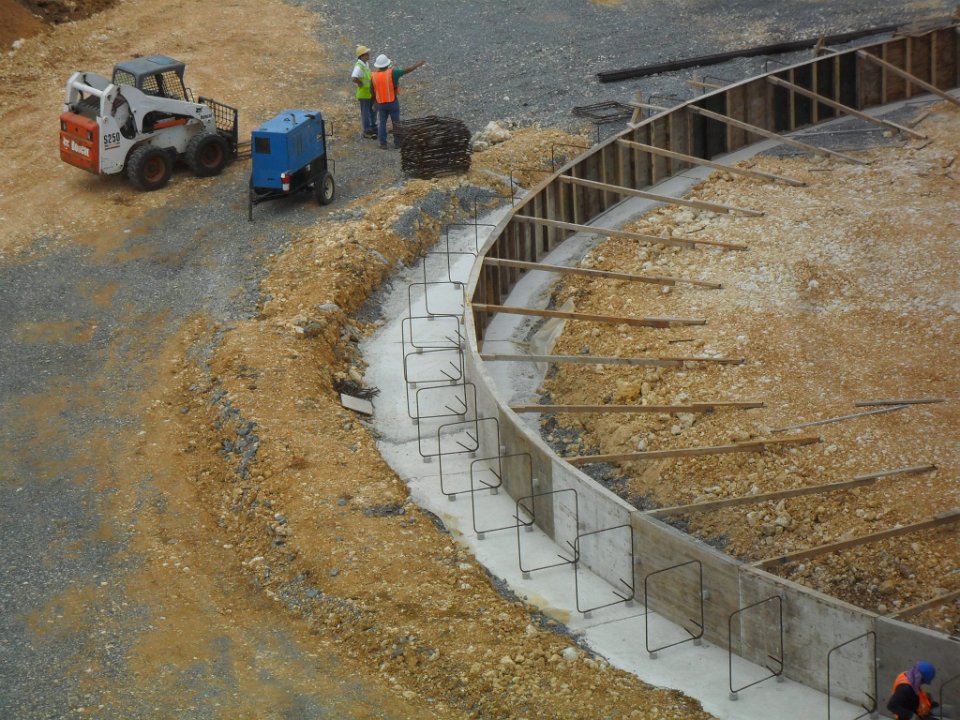

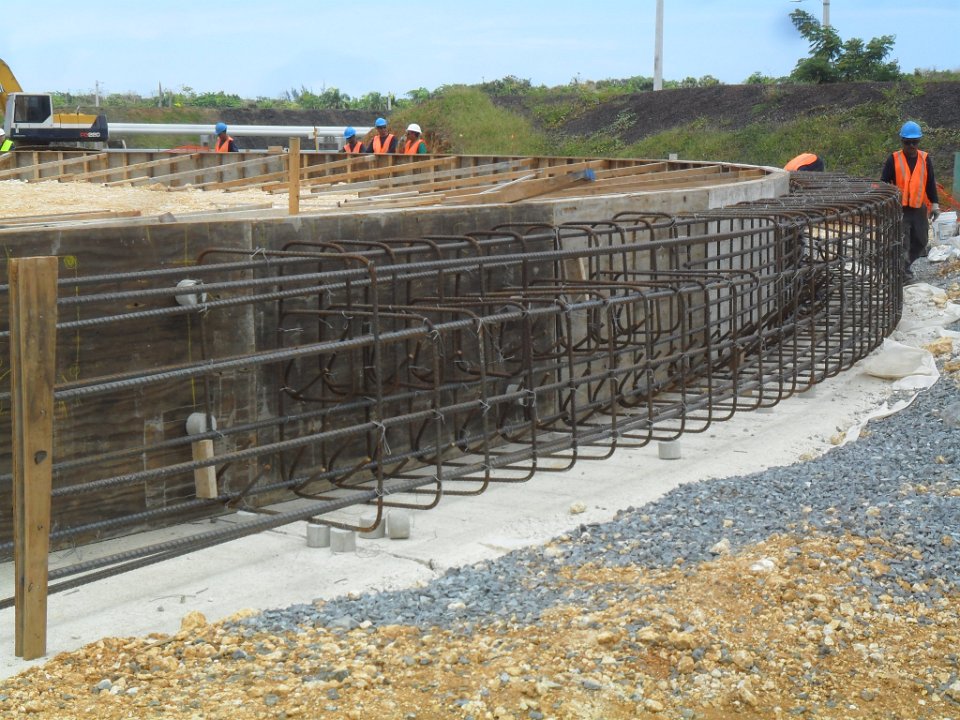

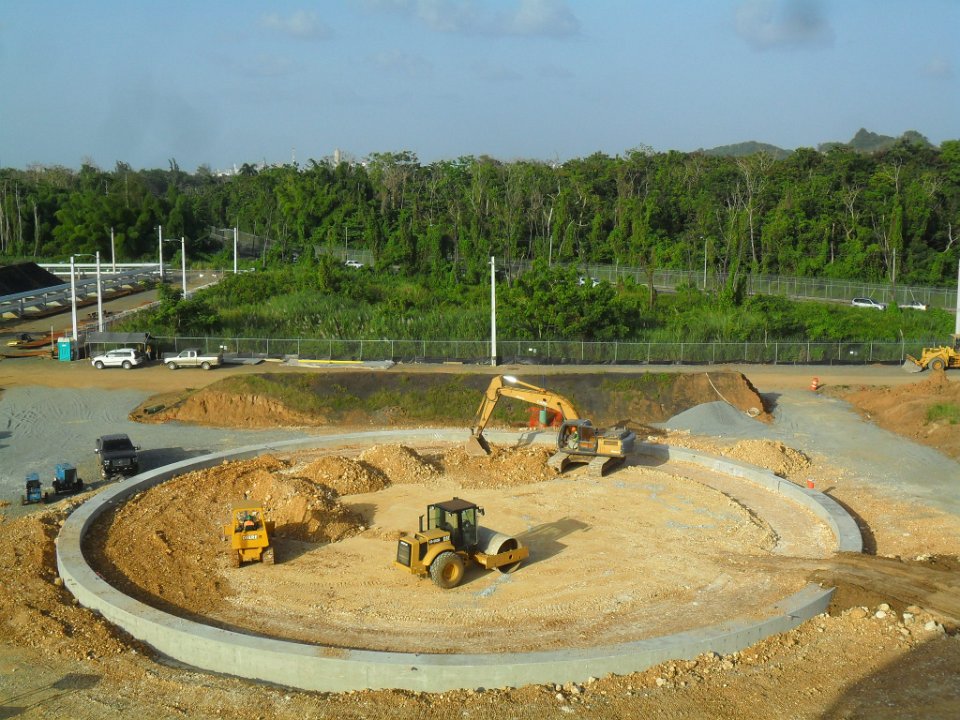

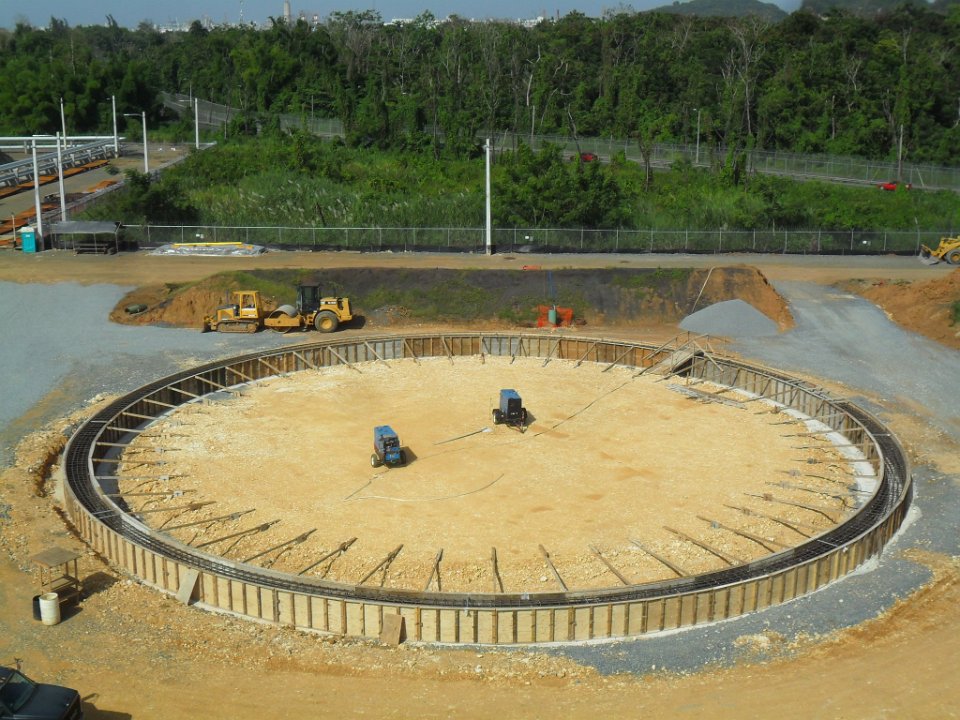

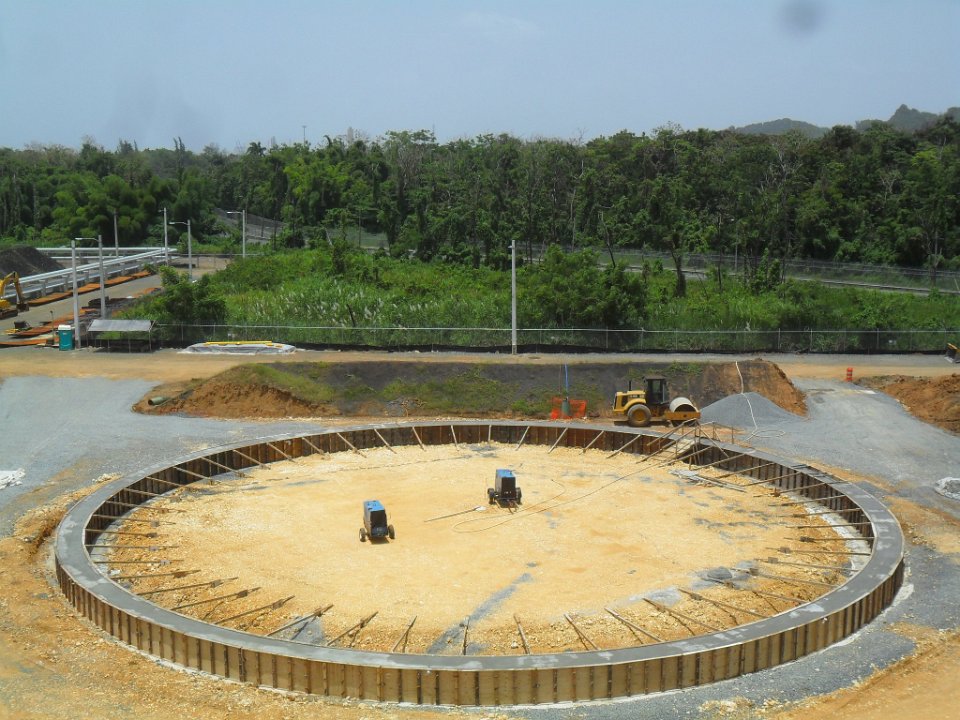

Civil works Structural Rebar 4 CONCRETE RING FORMWORK 5 CONCRETE RING POUR

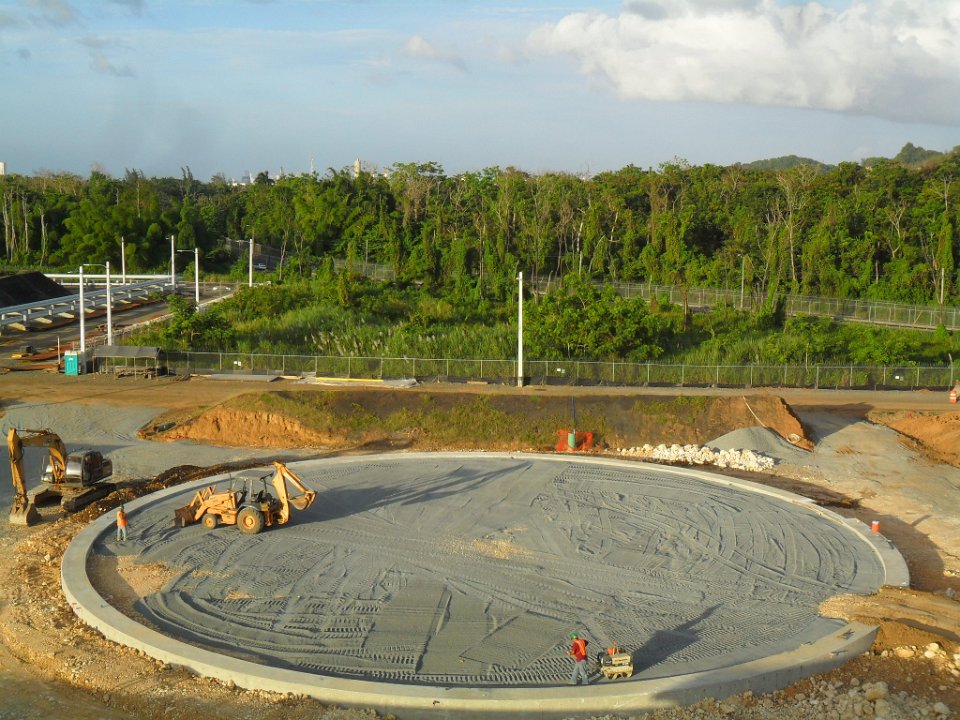

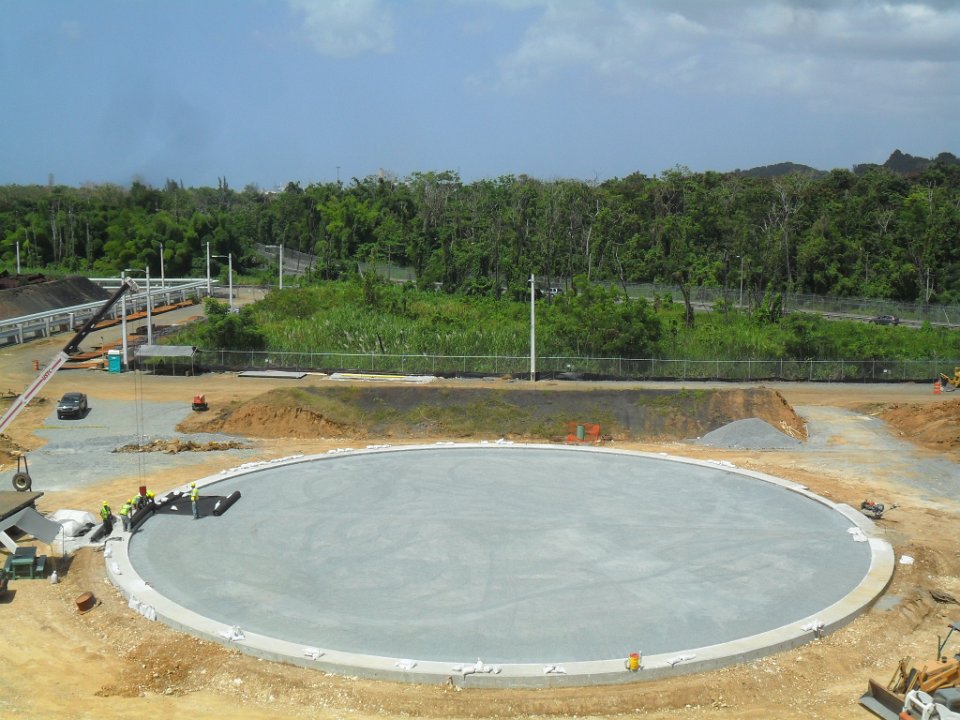

6 CONCRETE RING COMPLETE 7 LINER SUB BSAE 8 LINER SUB BASE COMPLETE Liner install

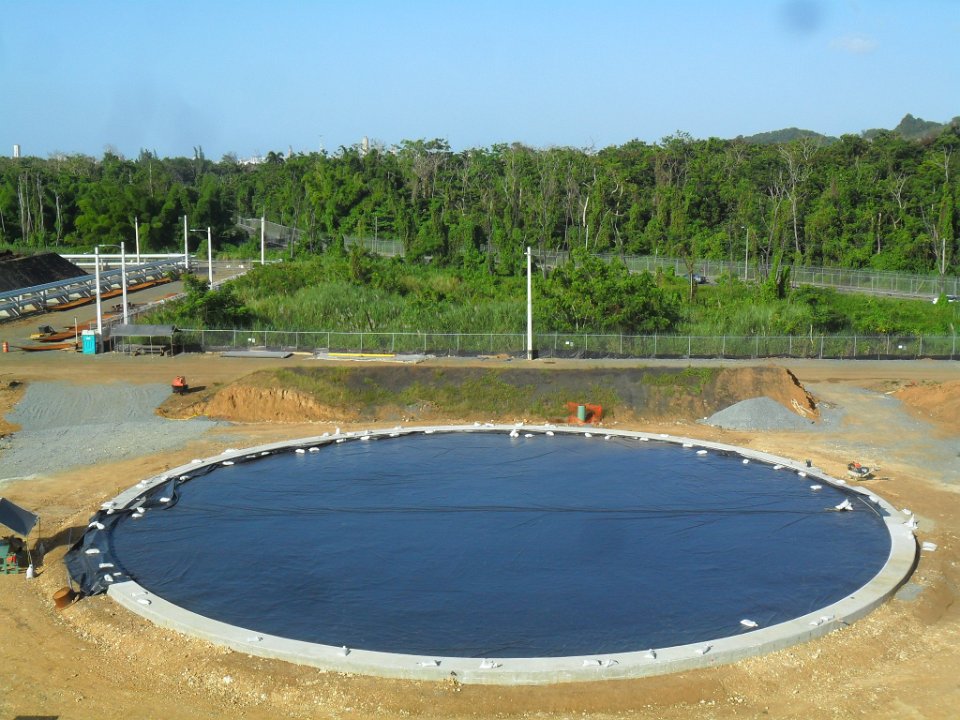

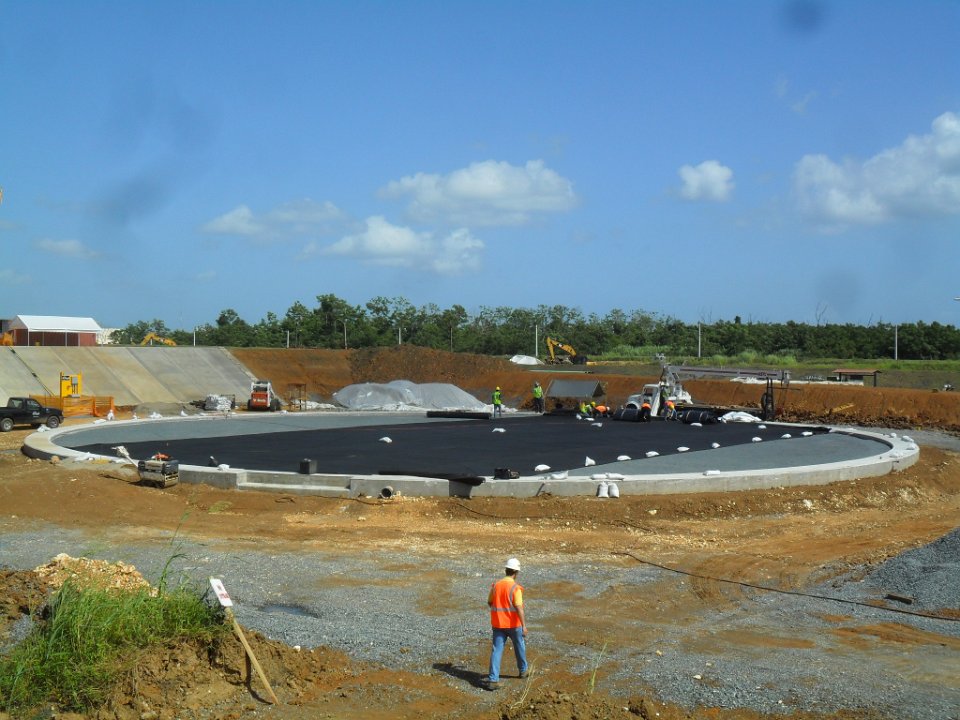

Sump Liner Leak Detection 9 LINER INSTALLATION 10 LINER INSTALLED

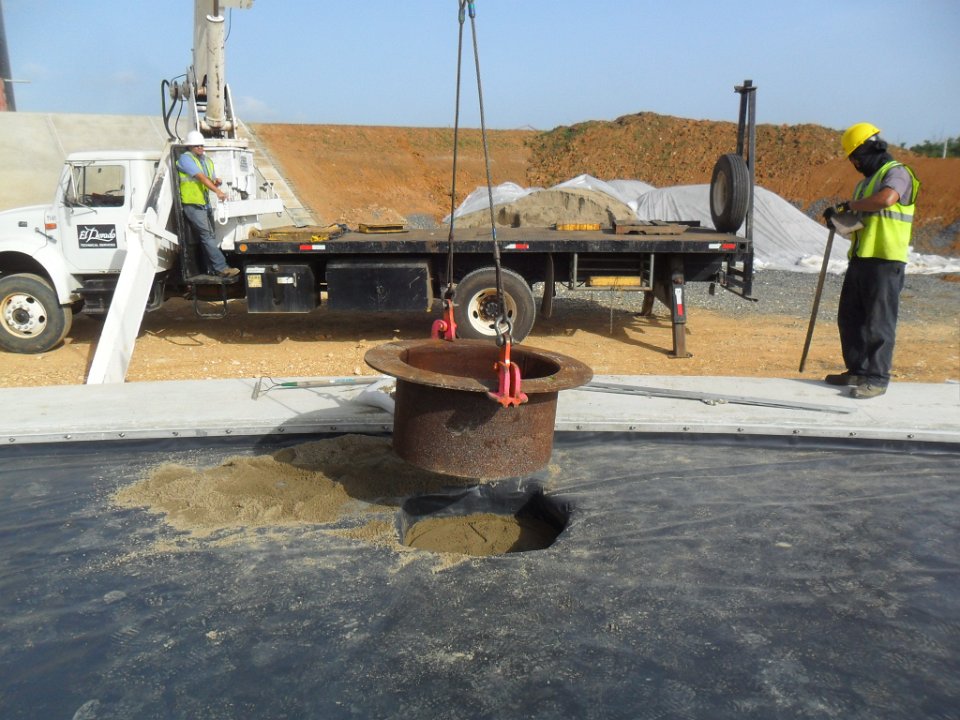

Sump Install Sand Bedding 11 SAND CUSHION COMPLETE 12 SUMP INSTALLATION

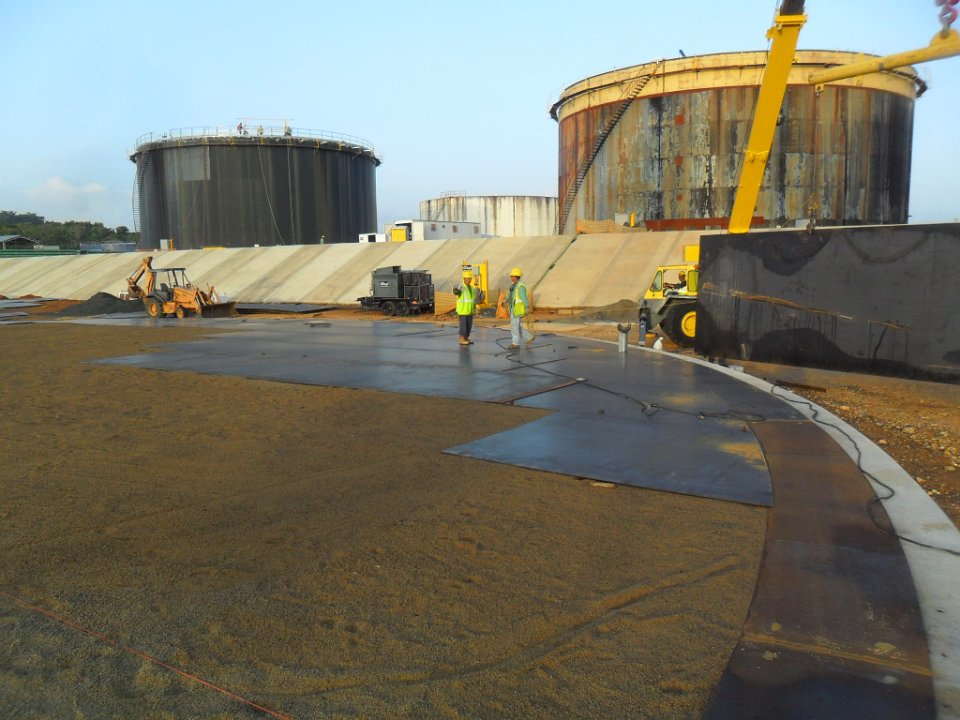

Asphalt board Isolation First Bottom Plates 13 BOTTOM PLATES INSTALLATION 14 SHELL FIRST RING

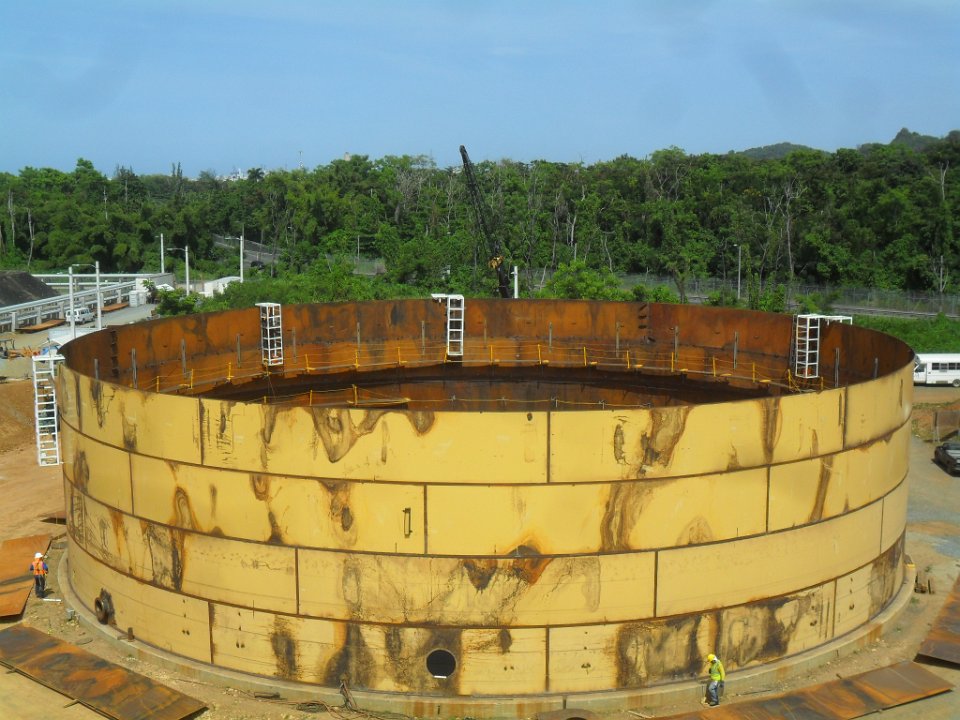

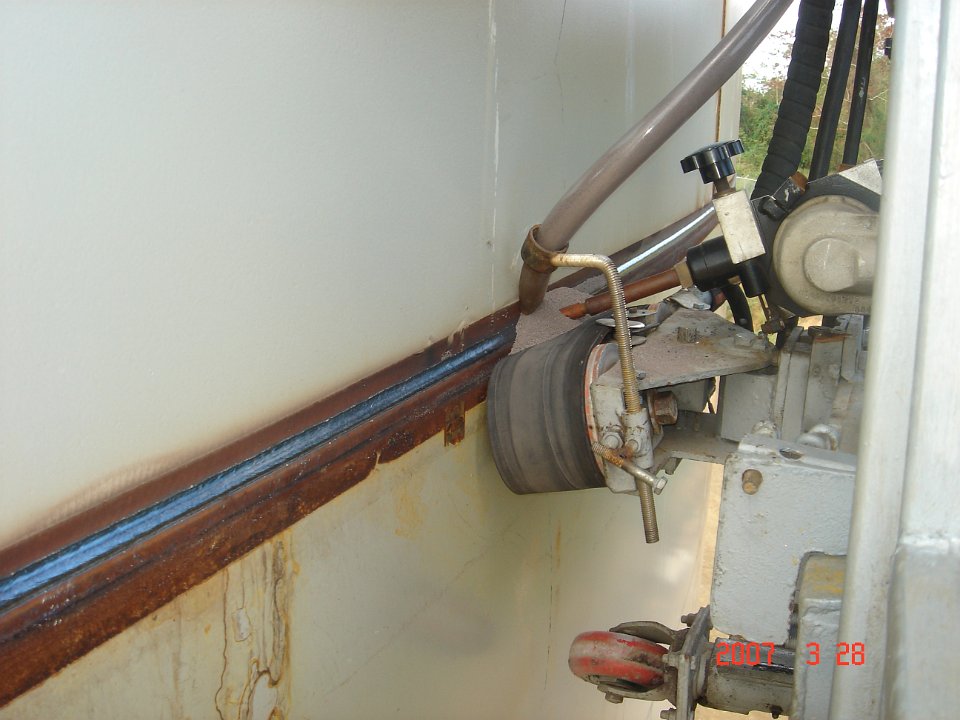

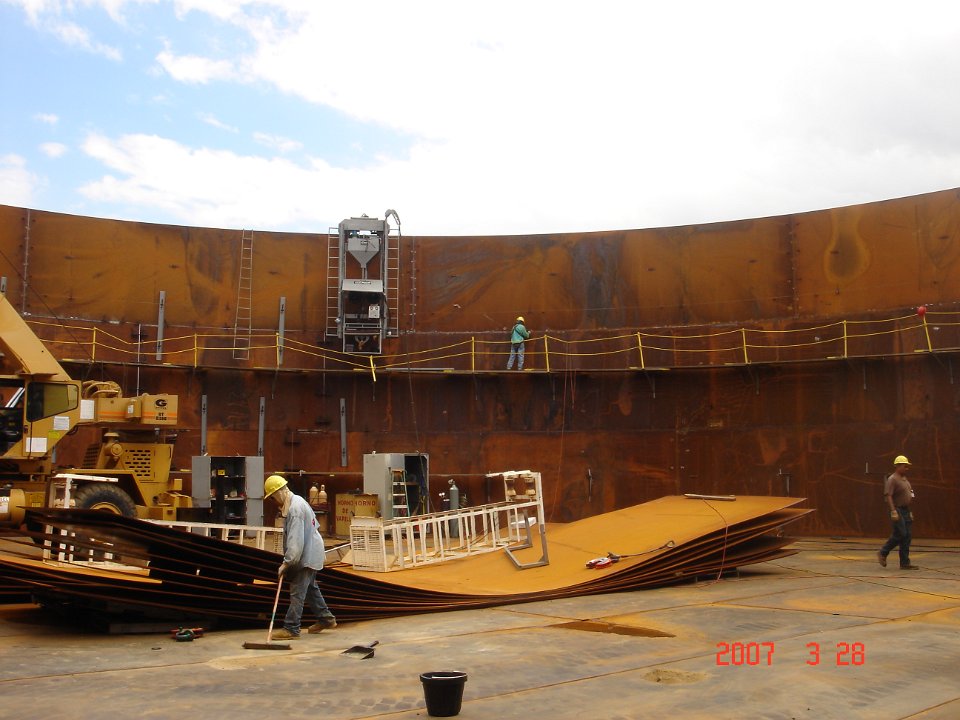

15 AUTOMATIC GIRTH WELDER 16 AUTOMATIC GIRTH WELDER FINAL PASS 17 WELDING VERTS 18  - 4 RINGS ERECTED

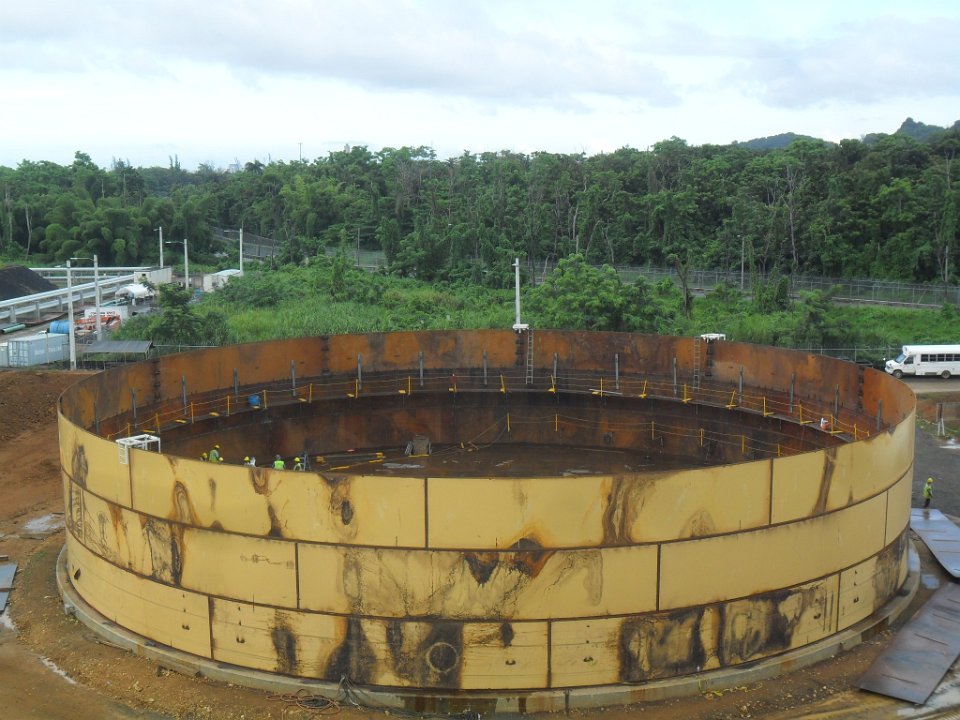

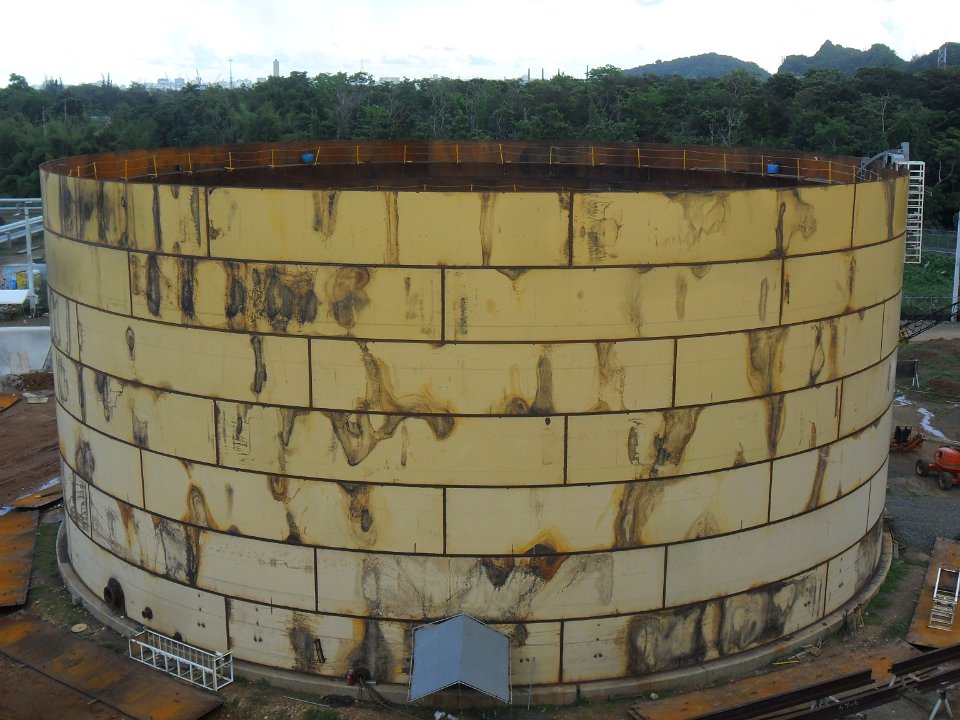

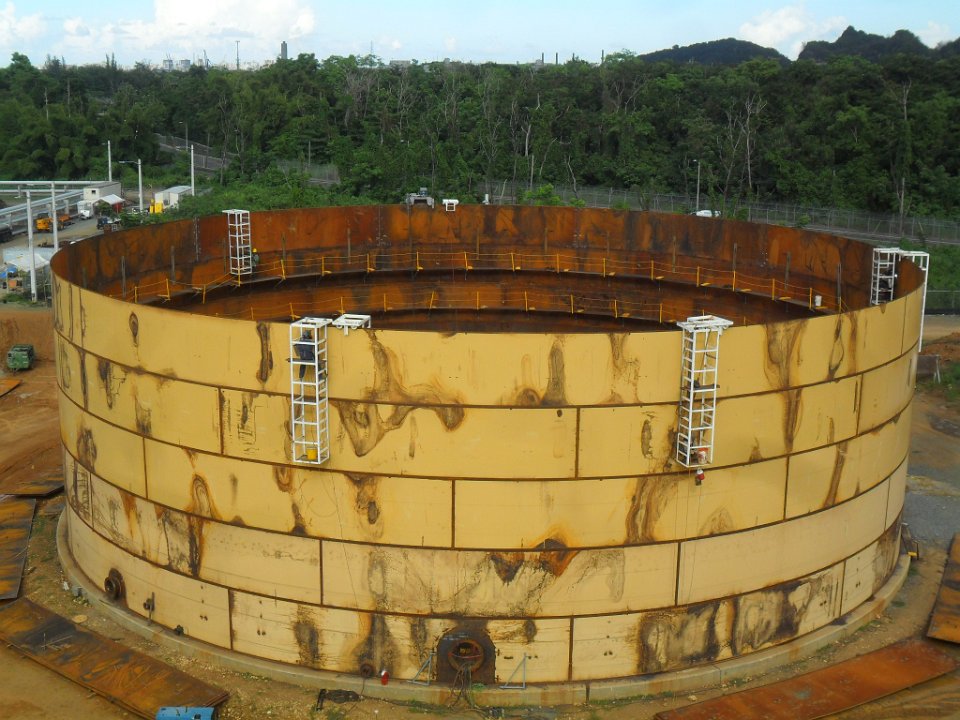

18 THREE RINGS ERECTED 19  - 5 RINGS ERECTED 20  - 6 RINGS ERECTED 21 SHELL HIGH

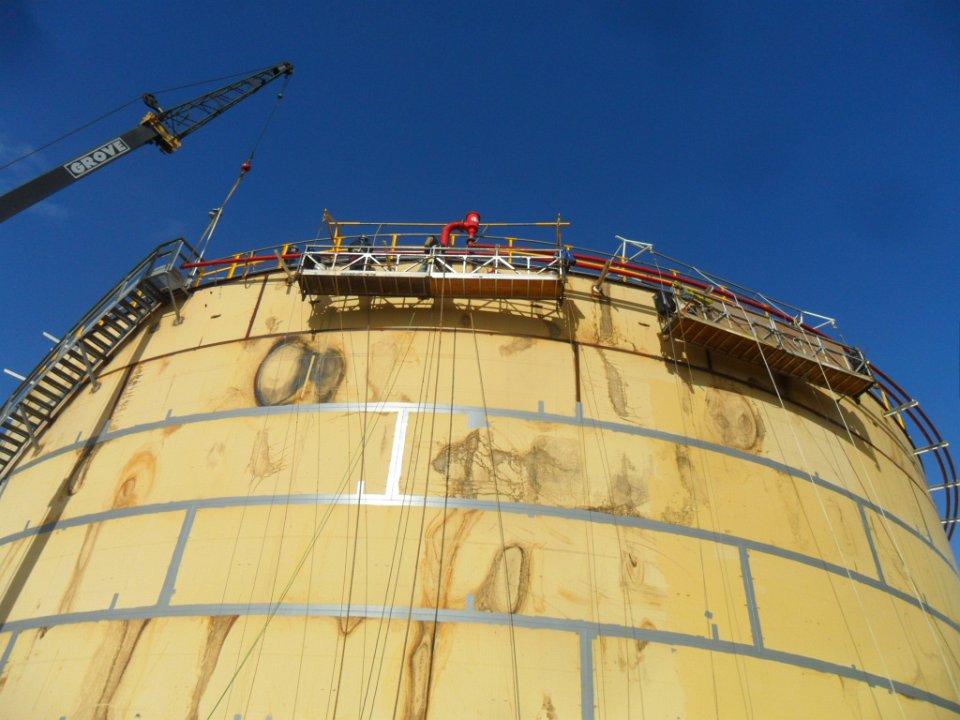

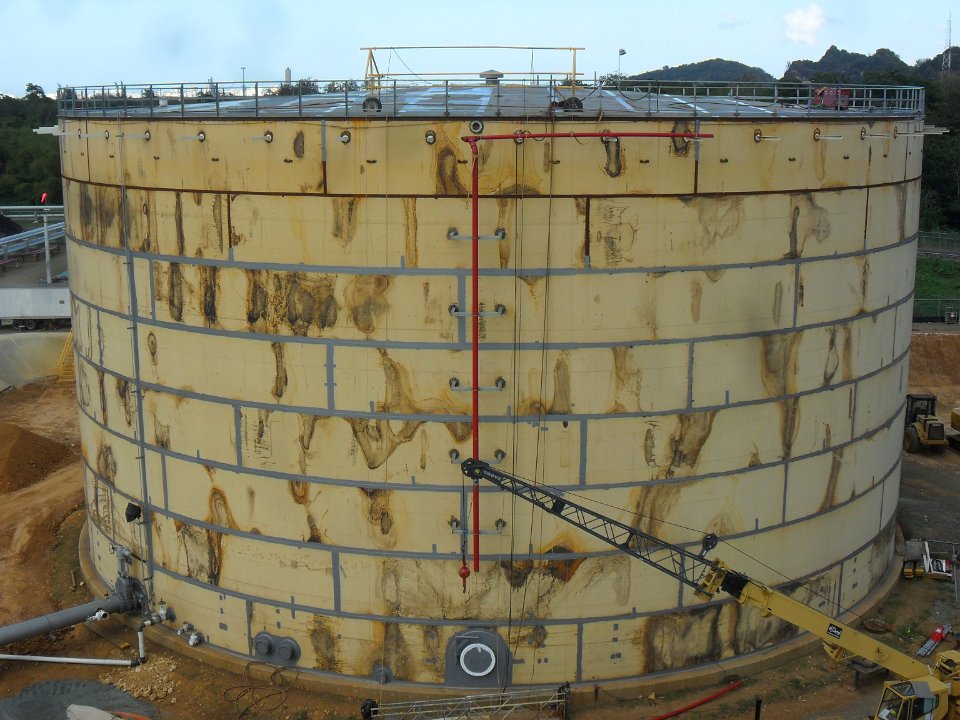

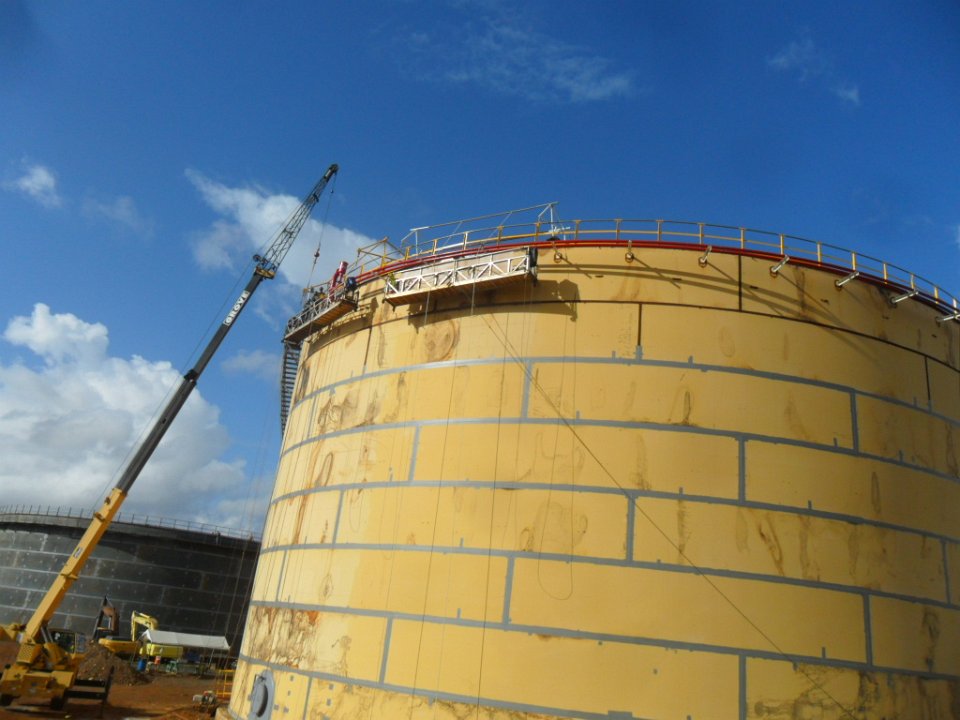

22 ROOF COMPLETE AND PAINTING Shell Strike Primer Shell Painting Painting

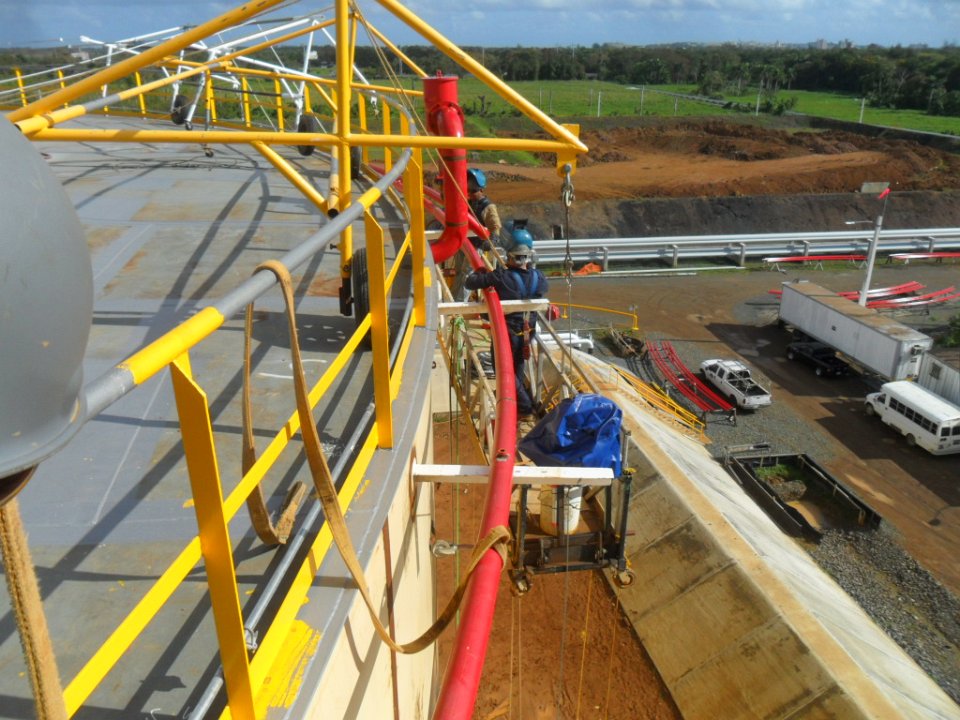

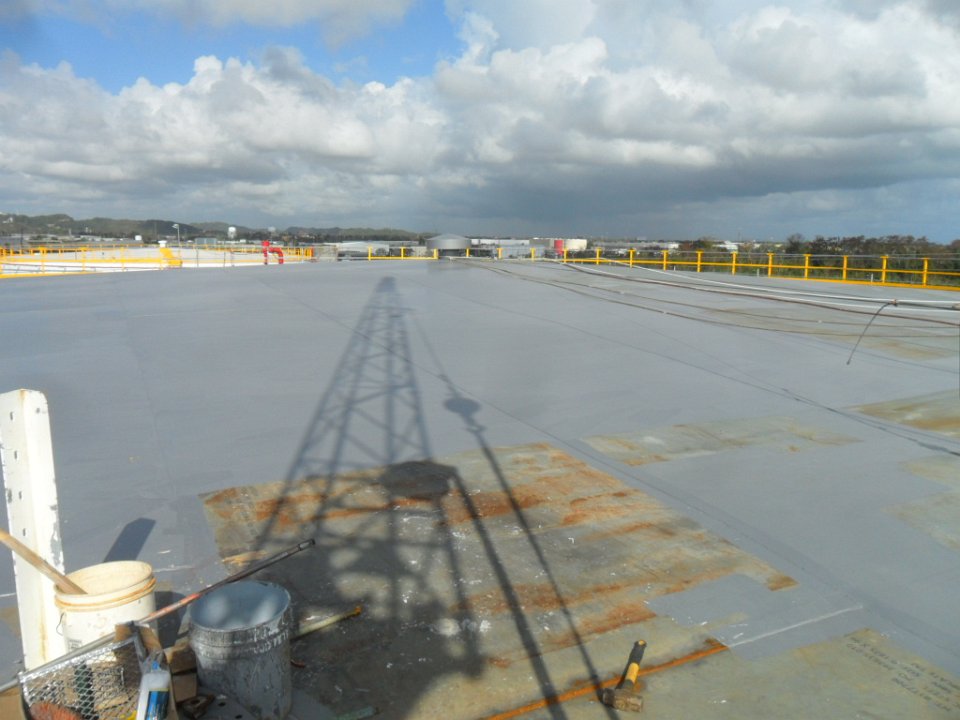

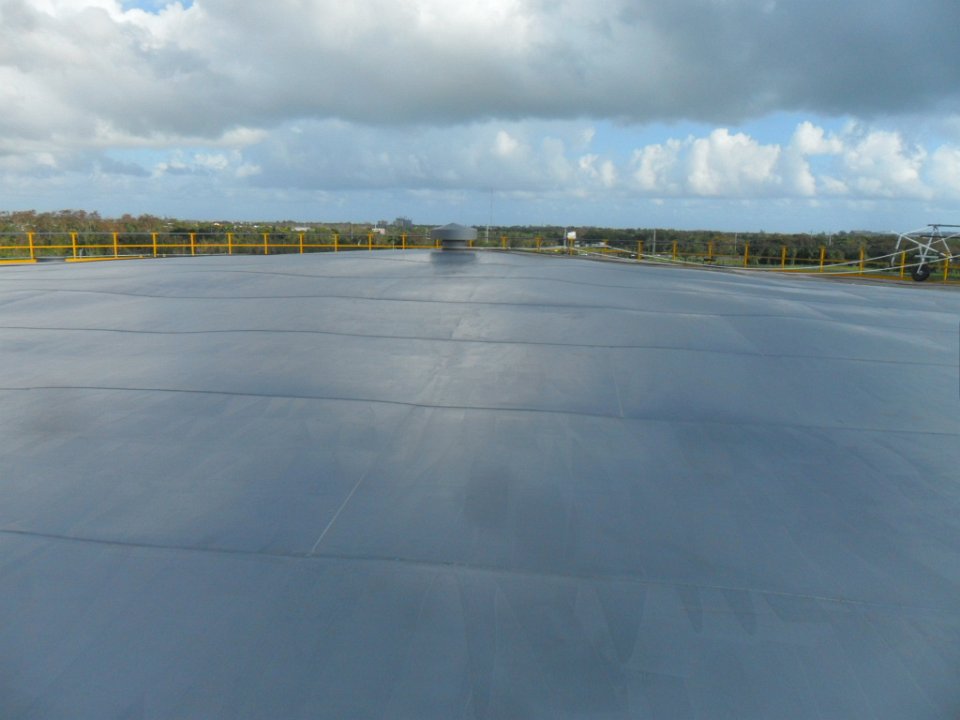

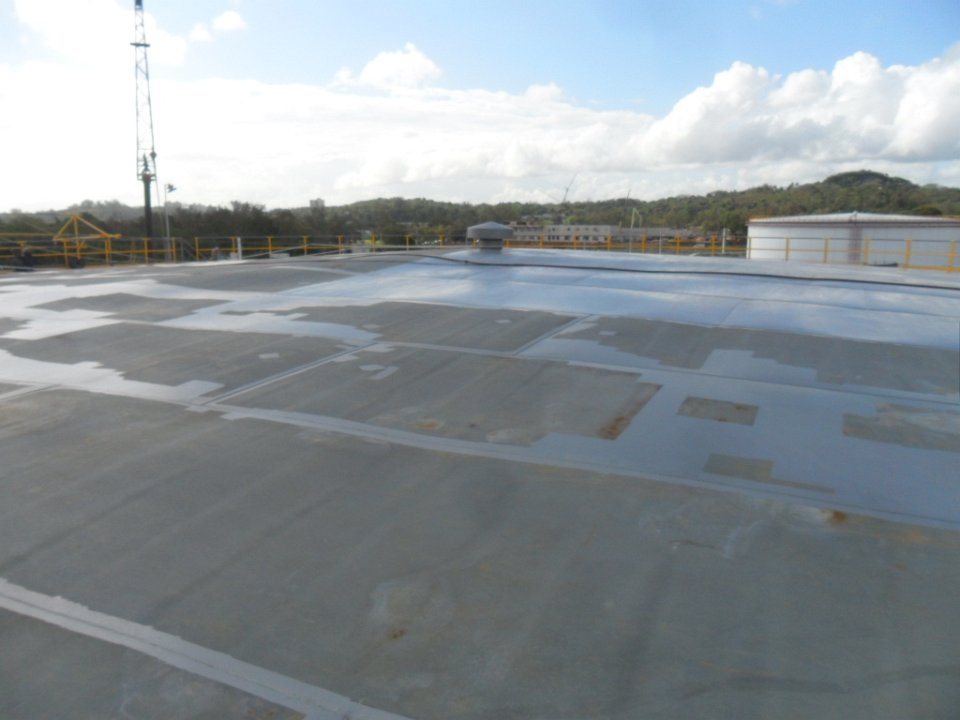

Roof Primer Roof Primer 1 Hoist Equipment Primer Complete

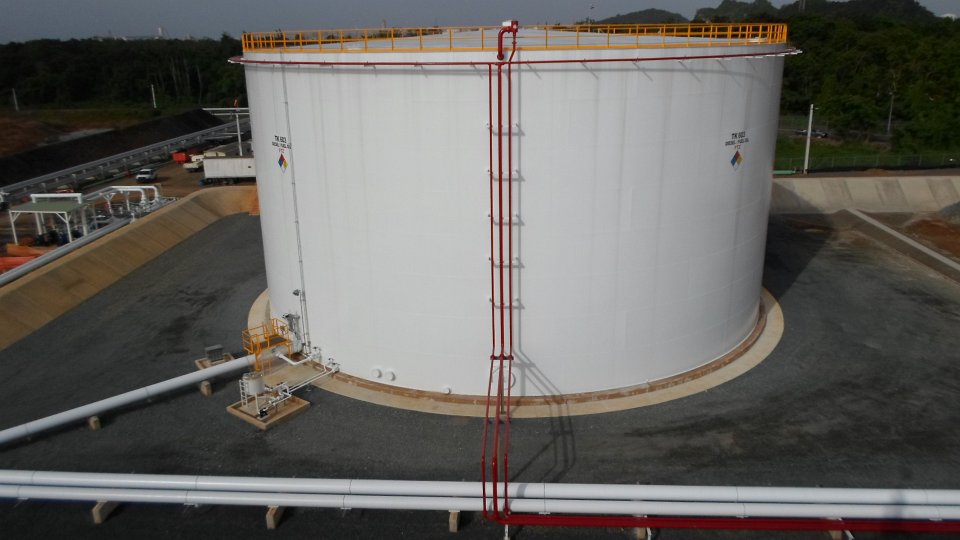

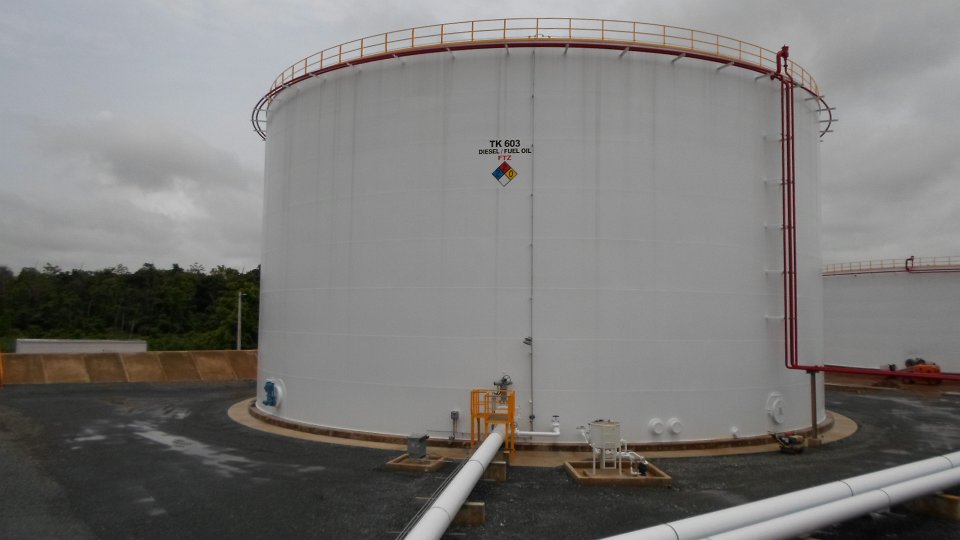

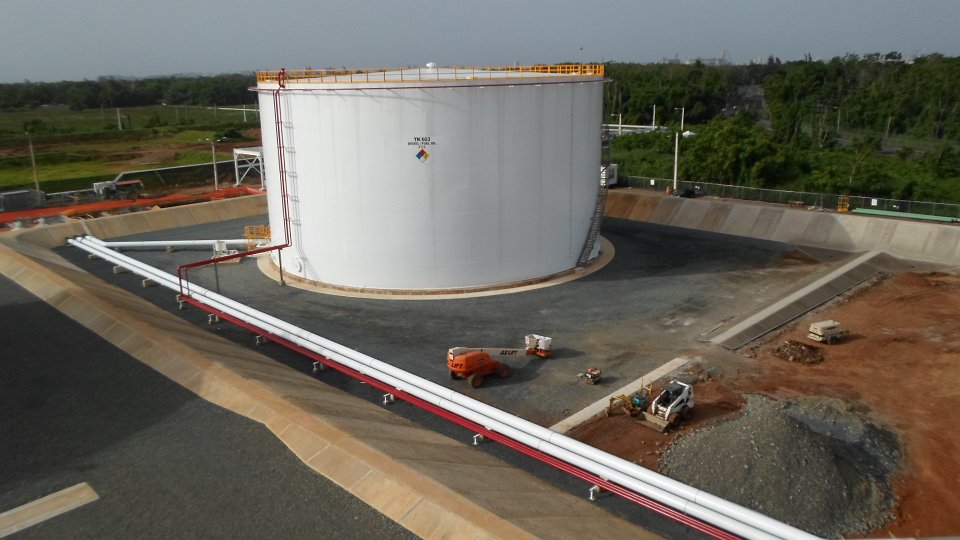

Tank Final 1 IMG 00002649 Tank Final 2 Tank Final 3

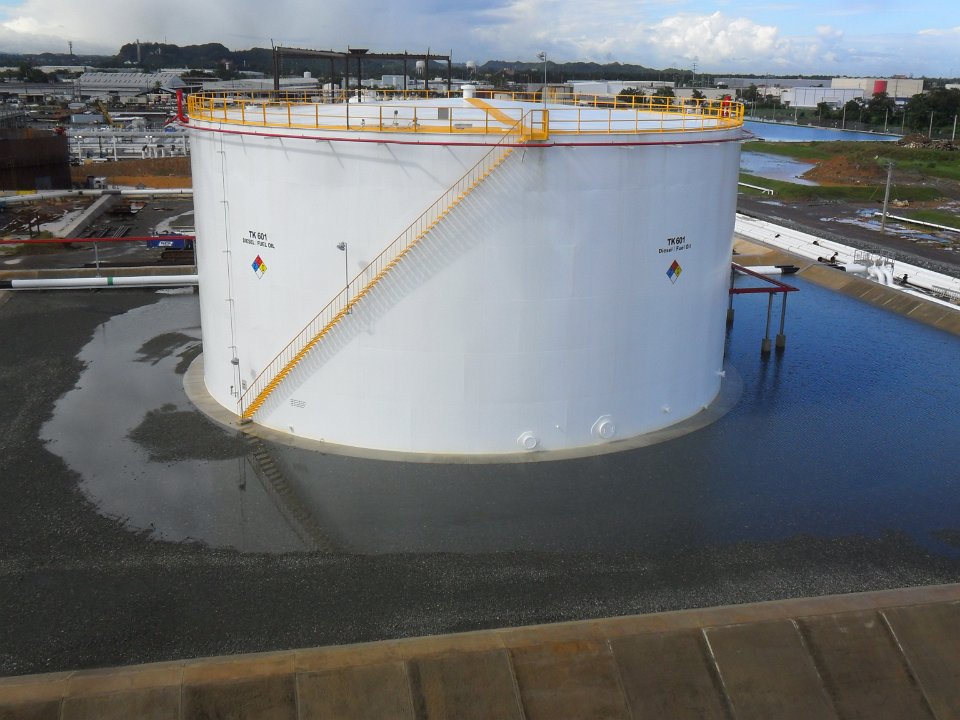

Tank Final 4
